Organise, Engineer, Save

Project info:
Companies Involved:
Marine Fabricators
Total Load Weight:
Over 1100 tonnes
Time To Load:
24 Working Hours
Origin:
North East UK
Destination:
Norway
Organise, engineer, save
As the cost of services, vessels, and transport continues to grow, efficiency is becoming more and more essential. Companies can waste a lot of time and money transporting heavy equipment without a well engineered plan.
A client recently approached us to find a solution for transporting 292 oddly shaped components to build an offshore carousel being built in Norway. The pieces at the time were spread across their fabrication site, having come back from the painters in slightly random orders.

A planning problem with an engineering solution
At the core of the challenge our client faced was a planning problem. They could find plenty of companies that would find them a vessel, but few teams could advise the optimised vessel selection, speed of loading and designing and providing the seafastenings for such an aray of cargo.
The challenge:
Organise, Engineer, Save
The benefit of engineering led shipping is that we see every transport challenge as an opportunity for an engineering solution. In order to move all the components from ports in the UK to Norway, we set about drafting meticulous plans for the kind of ship necessary, how each component could be secured and placed, and the best equipment for load in.
In reviewing our client’s needs, we discovered that the project needed a different vessel type than the one they were planning on because we could accomplish the load in without the need of welding. This means lower costs and faster loading and securing for our client.
The solution:
Increased freight rate, lower overall cost
Because of our approach to managing costs, we were able to accomplish the entire loadout with less equipment in 24 hours, including lashing and securing.
On paper, it was higher freight rate, but an overall lower project cost due to smaller cranes, quicker loading and no need for welding or removal of welds.
Twice the cranes, twice the speed

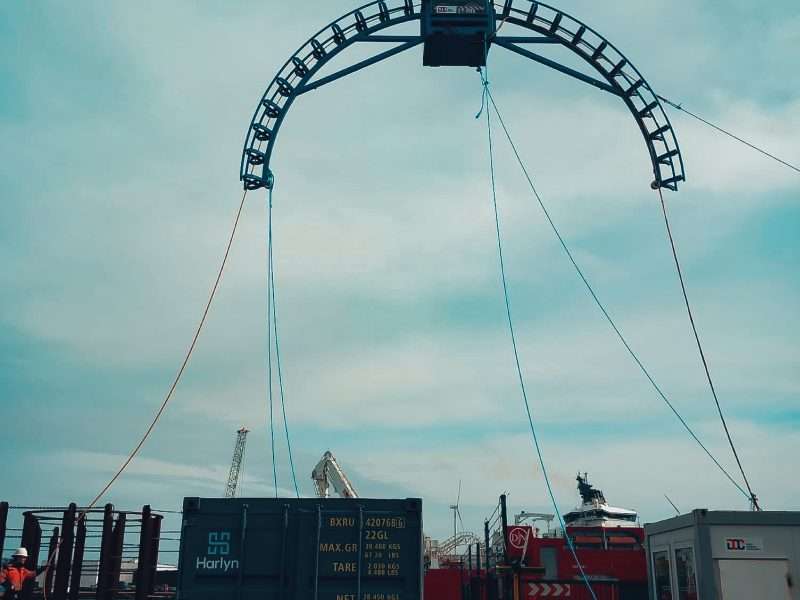

We loaded the vessel utilising two cranes, one larger and one smaller, we optimised the stow to allow this loading and meaning we could load across 86m of deck length from just one set of crane positions. This meant no down time in loading and cranes fully optimised. Two engineers worked hand in hand with the lift supervisors to coordinate the landing of the cargo.

Outcome
We’ll give you a solution so you can go back to changing the world.
When the project was over, we delivered the project as originally priced, without any need for variations, and all while working with a turnkey single source team.
A lower freight rate means nothing if the project itself is inefficient. We’d love to help you save where it really matters through our engineering-led approach.
If you have a transport challenge, give us a call, we’ll give you a solution, so you can go back to changing the world.

A credit to everyone involved.
Thanks for your excellent services on what I believe was a complex job. The whole operation ran smoothly and was completed in a timely manner - a credit to everyone involved.
Marine Fabricatiors
Engineering-led transportation
in action.
Transporting OSPs for a flagship windfarm in Moray West
Distance Weight Location Destination 300 miles 1400 tons Newcastle Moray West
View case study
Moving two 180 tonne Fibre Optic Cables
Harlyn Solutions was appointed by Sumitomo Electric Corporation to manage the transport and handling of two fibre optic cables from Sweden to Pembrokeshire, Wales, for offshore installation. Our team developed the vessel loading solution, coordinated onshore and offshore operations, and managed the return, spooling, and transport of remaining cable and equipment — delivering a smooth, efficient end-to-end operation.
View case study
Lifting a 170 tonne linkspan to its new facility in Liverpool

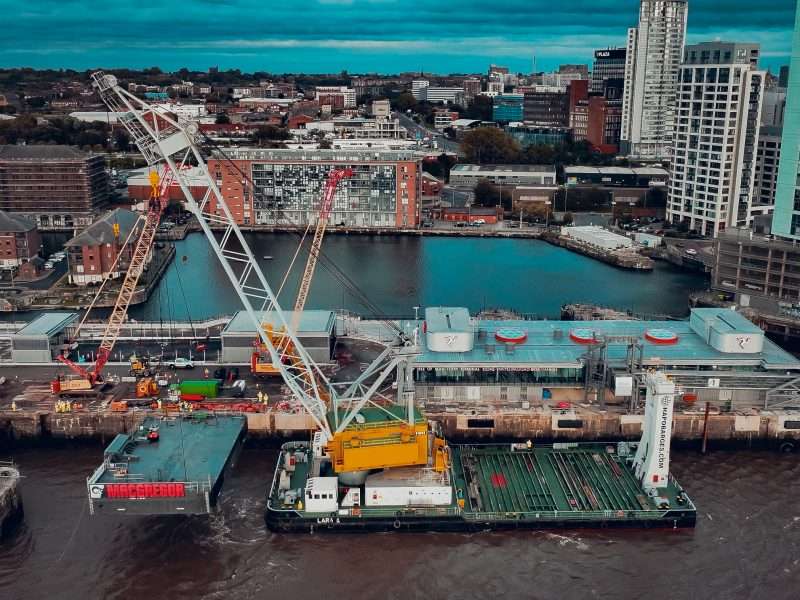

Harlyn Solutions worked with MacGregor to lift and install a linkspan at the new Isle of Man Ferry Terminal in Liverpool — completing a complex, multi-phase project spanning 30 months. From transport from Poland to final installation, our team provided flexible, responsive support and acted as a single point of contact to manage evolving challenges efficiently.
